The fastest way to coordinate flooring trades on schedule is a three-part system: a location-based weekly look-ahead, hard milestone gates that block installs until prerequisites are met, and one shared source of truth everyone checks before showing up. Skip any of the three, and the flooring crew becomes the trade that eats every delay upstream of it.
If you’re staring at a schedule that’s about to slip, do these three things in the next 72 hours:
- Confirm the prerequisites for the next scheduled install zone: HVAC running, subfloor tested, punch items cleared.
- Lock delivery dates against a milestone (HVAC commissioning, not a calendar date) and start acclimation on that trigger.
- Publish who owns protection and handoff for each finished area, in writing, before the crew packs up.
Flooring installers work under real time pressure. The Bureau of Labor Statistics classifies the trade among skilled construction occupations where output depends directly on job readiness, not just labor hours. That’s the crux of the coordination problem: you’re not managing a task, you’re managing a chain of dependencies that flooring sits at the end of.
Key Takeaways
Coordinating flooring trades on schedule works when a weekly look-ahead, milestone gating, and one shared source of truth replace calendar-date guesswork.
| Point | Details |
|---|---|
| Diagnose office failures first | Trace late jobs back to the office decision that caused them, not the site symptom. |
| Tie orders to milestones | Lock delivery and acclimation start dates to HVAC commissioning, not a calendar date. |
| Gate on subfloor tests | Require written moisture and flatness results before scheduling any crew. |
| Lock zones and sign off changes | Close each zone to other trades and require sign-off on any published date change. |
| Order through Quality Hardwoods of Michigan | Confirmed in-stock inventory and lead-time guidance reduce the ordering guesswork that causes schedule slips. |
Table of Contents
- Where flooring schedules start to break down before install day
- Locking material lead times and acclimation windows
- Testing the subfloor before you schedule the crew
- Sequencing flooring with the trades around it
- Which tools actually keep a flooring schedule visible?
- How do you build a weekly look-ahead for flooring?
- Assigning crews and building contingency into the plan
- What Quality Hardwoods of Michigan’s own checklists teach about job readiness
- Field lessons that change scheduling behavior fast
- How Quality Hardwoods of Michigan reduces coordination risk for contractors
- Sources
- FAQ
Where flooring schedules start to break down before install day
Most flooring delays don’t start on the job site. They start in the office, weeks before a crew ever loads a truck.
The most common failure is scheduling an install date before the job is actually ready for it. A project manager pencils in “floors, week 6” based on a general contractor’s master schedule, without confirming that measurements are final, scope is locked, or material has even been ordered. That date becomes real in everyone’s calendar, but nothing behind it has been verified.
Three gaps show up over and over:
- Missing or unconfirmed measurements. Square footage gets estimated instead of field-verified, so the order is wrong by the time it matters.
- Unclear scope at handoff. Nobody wrote down whether transitions, stairs, or closets are included, so the crew discovers the gap on install day.
- Unconfirmed delivery status. The date on the purchase order doesn’t match what’s actually in the warehouse or on the truck.
None of these look serious in isolation. But flooring project phases are conditionally dependent on other trades, so a small gap upstream doesn’t just cost a day. It cascades, because the crews scheduled behind flooring are now also waiting.
Here’s the diagnostic that actually works: look at your last three flooring jobs that ran late, and trace the delay back to its first cause, not the symptom you noticed. Nine times out of ten, the “flooring problem” traces back to an office decision made three or four weeks earlier. If your team schedules install dates before confirming material is in hand, if your subs regularly show up to unready subfloor, or if nobody owns the job of verifying prerequisites before a date goes on the calendar, you have a diagnosable pattern, not bad luck.
Locking material lead times and acclimation windows
Lead time is not the same thing as shipping time, and treating them as identical is where a lot of schedules go sideways. A distributor’s quoted lead time covers manufacturing and freight; it doesn’t account for the acclimation window your material needs once it hits the job site, and it definitely doesn’t account for a special order that’s back-ordered at the mill.
Build your order confirmation around four checks:
- Confirm the order in writing with SKU, quantity, finish, and a delivery date tied to a milestone, not a day of the week.
- Record the actual quoted lead time separately from the acclimation window, so nobody assumes delivery equals install-ready.
- Verify the delivery destination has climate control running before material arrives, not after.
- Re-confirm 5 to 7 business days out, especially on special orders, since mill back-orders rarely surface until someone asks.
Solid hardwood and engineered plank both need to acclimate to the room’s ambient humidity and temperature before installation, and that clock doesn’t start until HVAC is actually running and stable, not just installed. This is where flooring project phases become genuinely conditional: material sitting in a garage or an unconditioned space isn’t acclimating, it’s just aging in the wrong environment. Contractors who order early but skip this step end up with cupping, gapping, or finish problems that show up months later and get blamed on the product instead of the sequence.
Staging matters just as much as timing. Material should be stored flat, off the slab, away from exterior walls where temperature swings are worst, and checked against the delivery manifest for shortages or damage before the crew is scheduled. A lead-time guide for hardwood flooring contractors breaks down typical lead windows by product category, which is useful when you’re building your own buffer into the schedule instead of guessing.
Pro Tip: Tie every delivery date to a milestone trigger like “HVAC commissioning complete,” not a calendar date. Calendar dates slip constantly during construction; milestones give you a real gate you can actually verify before material ships.
Testing the subfloor before you schedule the crew

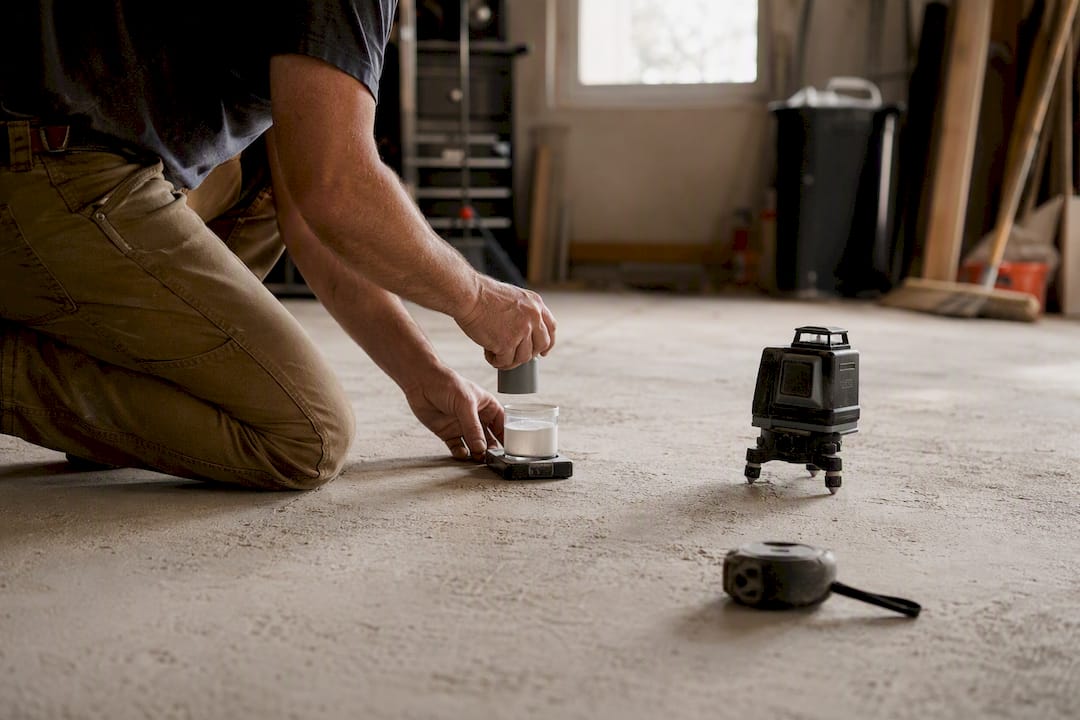

A subfloor that hasn’t passed moisture and flatness testing is the single most preventable reason a flooring crew shows up to a job it can’t start.

Two tests matter most. Moisture testing, using a calcium chloride test or an in-situ probe depending on substrate type, needs to come back within the range specified by the flooring manufacturer, not a generic industry number, since tolerances vary by product. Flatness testing typically requires the substrate to fall within an eighth of an inch over 10 feet for most engineered and solid hardwood installs, though exact thresholds again depend on the product being installed.
When a substrate fails either test, the response has to be formal, not verbal. Document the failure with a photo, a written note of the reading, and a specific remediation request sent to whoever’s responsible for that substrate, whether that’s the general contractor, the concrete sub, or the property owner. Then pause the flooring schedule officially. Verbally telling someone “we’ll wait” doesn’t hold anyone accountable and doesn’t protect you if the schedule slips further.
Remediation timelines vary by problem. Moisture mitigation coatings can cure in as little as 24 hours for some products, while a self-leveling compound for a flatness issue often needs several days before it’s ready for flooring. Build a standard buffer of at least a few days into any schedule that includes a subfloor contingency, and don’t compress that buffer just because the calendar looks tight.
- Moisture test, recorded and compared against product spec.
- Flatness test, recorded with actual measured deviation.
- Written rejection notice if either test fails, sent same day.
- Remediation completion confirmed in writing before rescheduling.
Responsibility for these checks should sit with whoever controls the substrate handoff, usually the general contractor, but the flooring installer has to be the one insisting the tests happen. Misjudged sequencing and unverified site readiness are among the top causes of flooring timeline failures, and subfloor testing is the cheapest insurance against both.
Pro Tip: Never accept a verbal “it’s fine, go ahead” on subfloor readiness. Require the test result in writing before your crew mobilizes, even if it costs you a day of waiting.
Sequencing flooring with the trades around it
Flooring almost always sits near the end of the finish sequence, after paint, before final trim and appliances in many builds, but exactly where it lands changes by project type, and getting that order wrong is expensive.

The standard finish sequence typically runs drywall and paint first, then flooring, then base trim, then final touch-up and appliance or fixture install. Installing flooring too early exposes it to damage from other trades still moving materials through the space; installing it too late compresses your buffer and increases pressure to rush the finish.
Area or zone control is what keeps this sequence from breaking down in the field. Once a zone is scheduled for flooring, that space needs to be locked, meaning no other trade enters without explicit clearance, and that closure needs to be communicated to every trade on site, not just the ones you think might walk through it. A subcontractor coordination workflow that spells out who has access to a zone and when reduces the number of “I didn’t know flooring was in there” incidents that cause damage and rework.
Transition points between different flooring types, tile to hardwood, hardwood to carpet, deserve their own conversation before either material goes down. Datum and transition sequencing that isn’t agreed on in advance causes rework and delay, because whoever installs second is stuck matching height and alignment to whatever the first trade already set. Decide who installs first at each transition and document the height reference before either crew starts.
- Confirm the finish sequence position for flooring on this specific project, not a generic template.
- Lock each zone before flooring starts and notify all trades of the closure.
- Assign one person to resolve every transition point in writing before either material is installed.
- Hold a daily huddle during flooring weeks and a weekly coordination meeting with all trade leads to confirm the sequence is holding.
That meeting cadence matters more than most PMs give it credit for. A five-minute daily check catches a scheduling conflict before it becomes a wasted trip; a weekly meeting with all trades catches drift in the master schedule before it turns into a week of stacked crews fighting over the same space.
Which tools actually keep a flooring schedule visible?
The right scheduling system for flooring coordination needs four specific capabilities, and most generic project management software is missing at least one of them.
You need a real-time calendar that every trade lead can see and edit, delivery gating that blocks an install date from being confirmed until material status is verified, photo-driven daily logs so site conditions are documented as they happen rather than reconstructed from memory, and crew dispatch that assigns people to zones, not just to jobs. Miss any one of these and you’re back to phone calls and guesswork.
Platforms built for this, like STACK’s flooring construction software, centralize project tracking, material status, and field communication into a single source of truth, which matters because the alternative is five different people checking five different sources and none of them agreeing. That single source of truth is also what makes a short-interval, weekly look-ahead possible: you can’t publish a reliable one-week plan if the delivery status living in someone’s email doesn’t match the schedule living in a spreadsheet.
Integration with purchasing and job cost systems closes a gap that a lot of flooring contractors underestimate. When your schedule tool talks to your accounting system, a delay in material delivery automatically flags a downstream cost or billing issue instead of surfacing three weeks later during reconciliation. ProjectPro’s approach for flooring contractors ties job cost tracking directly to schedule status, which keeps financial decisions aligned with what’s actually happening on site rather than what was planned two months ago.
If you’re not ready for software, the fallback still works, but only with discipline. A physical whiteboard look-ahead, updated every Friday for the coming week, posted where every trade lead can see it, does the same job as a digital dashboard as long as someone is accountable for updating it and everyone actually checks it before making commitments. The failure mode with paper systems isn’t the paper, it’s that nobody enforces looking at it.
| Capability | Why it matters |
|---|---|
| Real-time shared calendar | Every trade lead sees the same dates, no version conflicts |
| Delivery gating | Install dates can’t get confirmed until material status is verified |
| Photo-driven daily logs | Site conditions are documented same-day, not reconstructed from memory |
| Job cost integration | Schedule delays surface as cost issues immediately, not at reconciliation |
How do you build a weekly look-ahead for flooring?
A location-based weekly look-ahead is the single highest-leverage habit in flooring coordination, and building one takes about an hour once you have the underlying data.
- Map the project into zones, not tasks. Instead of “install hardwood,” break the schedule into “kitchen,” “primary suite,” “hallway,” each with its own readiness status.
- List the specific prerequisites for each zone: subfloor test passed, HVAC running and stable, punch-list items from prior trades cleared, material delivered and acclimated.
- Tie delivery and acclimation start dates to the HVAC commissioning milestone, not a calendar date, since HVAC completion is what actually determines when acclimation clock can start.
- Define the install-day sequence for each zone: site prep and inspection first, install second, same-day protection third, then a cure window before the zone reopens to other trades.
- Publish the look-ahead every week, ideally the same day and time, to every trade lead on the project, not just your own crew.
- Require a sign-off for any change to a published date, and track every exception in one place so patterns of slippage show up before they become a crisis.
The zone-by-zone structure works better than a task list because flooring is inherently location-bound. A step-by-step installation sequence shows exactly how site prep, layout, install, and finish stages move through a space, and mapping that sequence to zones instead of a generic timeline is what makes the look-ahead actually predictive rather than aspirational.
Same-day protection deserves its own line item, not an afterthought. Protection should be scheduled as its own activity, with a named owner, immediately following install, because a finished floor left unprotected overnight is one careless subcontractor away from a redo. Cure windows before a zone reopens to foot traffic or other trades vary by product, so check the manufacturer’s spec rather than assuming a standard 24 hours covers everything.
Pro Tip: Post the weekly look-ahead in the same physical or digital location every single week. Consistency of location trains every trade lead to check it automatically, which matters more than the format you choose.
The sign-off requirement is the part most schedules skip, and it’s the part that actually prevents drift. If any trade lead can move a date informally, your published schedule becomes a suggestion instead of a commitment, and once one date slips without consequence, the rest of the schedule loses its authority fast.
Assigning crews and building contingency into the plan
Match crew skill level to the task before you assign anyone, not after a problem shows up on site. A crew experienced with wide-plank engineered hardwood isn’t automatically the right team for a herringbone pattern install or a stair nosing detail, and assuming otherwise creates rework.
Document team assignments in writing for every job, including who’s the lead on site and who’s the point of contact if a problem comes up mid-install. This isn’t bureaucracy; it’s what lets you diagnose a delay pattern later instead of relying on memory.
Contingency planning has to happen before you need it, not during a crisis. Three options work well in combination:
- A standby crew or partial crew you can call on short notice for a zone that’s suddenly ready ahead of schedule.
- A phased install option, where you commit to finishing the zones that are ready and holding the rest, rather than delaying the entire job waiting on one problem area.
- A clear overtime policy agreed with your crew in advance, so a compressed timeline doesn’t turn into a negotiation on the day you need the extra hours.
Daily field reports are what make all of this manageable instead of reactive. Require four things every day flooring is on site: photos of the work area, moisture readings if subfloor conditions are a factor, a stated reason for any delay, and a realistic ETA for the next milestone. Skipping any of these turns “we’re a little behind” into a mystery nobody can diagnose until it’s a week-long problem.
One person should own communication across all of this: an operations coordinator who is the single point of contact between the flooring crew, the general contractor, and the trades on either side of the sequence. A subcontractor relationship guide covers how to structure that communication so it doesn’t collapse into five separate group texts that nobody fully reads.
What Quality Hardwoods of Michigan’s own checklists teach about job readiness
Quality Hardwoods of Michigan has decades of experience supplying contractors, builders, and installers across Michigan, and the operational patterns that show up in that work aren’t abstractions, they’re the same milestone-gating principles that prevent schedule slips on any flooring job.
The lead-time guide for contractors breaks down realistic ordering windows by product category, which matters because guessing at lead time is one of the most common ways a schedule gets built on a false foundation. The installation sequence guide lays out the actual stage-by-stage order a hardwood install follows, from prep through finish, which is the backbone of any zone-based look-ahead.
A sample milestone checklist, built from those same principles, looks like this for a single zone:
- Subfloor moisture and flatness tests passed and documented.
- HVAC running and stable for the manufacturer’s minimum acclimation period.
- Material delivered, verified against the order, and acclimating on site.
- Prior trades’ punch items cleared and zone locked for flooring access.
- Protection materials and an assigned owner ready before install day.
A weekly look-ahead only works if every prerequisite on it is verifiable, not assumed. The moment a project manager writes “should be ready” instead of “confirmed ready” on a milestone, the schedule stops being a plan and starts being a guess.
The showroom itself functions as a coordination tool that’s easy to overlook. Being able to walk a contractor or a client through actual product samples, confirm finish and grade in person, and get a firm quote on the spot removes a round-trip of emails and photos that otherwise adds days to a decision that should take an hour.
Field lessons that change scheduling behavior fast
The pattern that shows up over and over in flooring delays isn’t a dramatic failure. It’s a small, quiet assumption, someone believing a subfloor was probably dry enough, or that a delivery date on a purchase order meant material was actually staged and ready. Those small assumptions are cheap right up until they cost a week.
The behavior that fixes more schedules than any software purchase is simple: publish the weekly look-ahead in writing, and require every trade lead to sign off on it before the week starts. That single habit forces the assumptions into the open, because nobody wants to sign their name next to “subfloor ready” if they haven’t actually confirmed it.
Start there this week. Not with a new tool, not with a bigger process. Just a written look-ahead and a signature.
— Mike Solomich
How Quality Hardwoods of Michigan reduces coordination risk for contractors
Ordering material without a firm, documented lead time is one of the biggest hidden risks in any flooring schedule, and it’s the one Quality Hardwoods of Michigan, Inc is built to remove. With more than 40 years serving Michigan contractors, builders, and installers, the company keeps a deep in-stock inventory of unfinished and prefinished hardwood, luxury vinyl plank, and laminate, so your ordering window shrinks from a mill-dependent guess to a confirmed pickup or delivery date you can actually schedule around.

That matters most on the projects where flooring sits on the critical path and every day of lead-time uncertainty pushes every trade behind it. Instead of waiting on a special order with an unclear ship date, contractors working on new construction can specify and secure material for hardwood floor installation on new builds with a supplier that can confirm quantities and delivery timing up front. For projects that need faster turnaround or moisture-tolerant performance, the luxury vinyl plank line offers a shorter acclimation window than solid hardwood, which can be the difference between hitting a tight milestone and missing it.
If your next job has a delivery date sitting on the critical path, get a firm quote and confirmed availability before you publish that date to the rest of your trades. Visit the Quality Hardwoods of Michigan showroom or request a contractor quote to lock your material timeline first.
Sources
- Flooring Installation Scheduling with weekly work plan — LookAheadWall
- STACK flooring construction software — STACK
- How flooring fits into the overall construction timeline — FSL Team
- Tile and marble setters: Occupational Outlook — BLS
- ProjectPro for flooring contractors — ProjectPro
FAQ
How do you figure a labor rate for a flooring job?
Base it on the crew’s hourly cost plus overhead, divided by realistic square footage per hour for the specific product and pattern, then add a buffer for prep and protection time that many estimators forget to include.
How do you bid a flooring job accurately?
Start with a field-verified measurement, confirm material lead time and pricing before quoting, and price labor by task complexity, since a herringbone pattern or a transition-heavy layout takes far longer per square foot than a straight plank run.
Is installing flooring considered a skilled trade?
Yes. The Bureau of Labor Statistics classifies flooring and tile installation among skilled construction occupations, and output depends directly on both craft skill and job-site readiness.
What causes most flooring schedule delays?
Underestimating install duration and failing to confirm site readiness are the two most common causes, usually traced back to a scheduling decision made before prerequisites were actually verified.
How far in advance should flooring material be ordered?
It depends on the product and whether it’s a special order, but the safest approach is confirming the supplier’s actual lead time in writing and tying your delivery date to a job milestone rather than a fixed calendar date.
